SUMMARY


JUNE – 2025



This month was marked by steady progress in earthwork and the preparation of building pads. The majority of construction contracts have already been awarded (85%), and the installation of utilities is scheduled to begin in the coming weeks, keeping the project on track according to the established timeline.
MAY – 2025
Construction Overview
The project officially commenced following approval from the city after installation of SWPPP controls and tree protection.
Ranger Excavating was mobilized on May 8, 2025, to begin site clearing and excavation.
Key sitework progress includes:
Clearing and grubbing of the site.
Road and building pad cuts completed.
Moisture conditioning of building pads and roads underway.
Four rain days impacted site activity during the month.
Site Logistics
Temporary restrooms installed for subcontractor crews; will be scaled based on manpower.
Temporary fencing scheduled for installation on July 7 to secure the site and prevent equipment conflict.
A weatherproof trailer foundation and parking pad will be poured by Best Ground Works to avoid rework.
Delivery of the construction trailer is expected by mid-July, once earthwork reaches a stable phase.
Manpower Summary
A total of 688 labor hours recorded in May.
Ranger Excavating: majority of sitework hours.
Landmark Companies Inc.: site supervision and project coordination.
Schedule Highlights
Earthwork: Ongoing from May 8 – August 4, 2025.
Sebastion & Italia Roads: May 8 – June 27, 2025.
Building Pads (1, 2, 3 & Garages): June 2 – July 11, 2025.
Retaining Wall Excavation & Foundation: June 2 – June 27, 2025.
Construction trailer setup and full site fencing: targeted for July.
Progress Photos

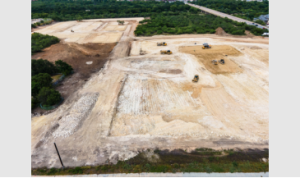

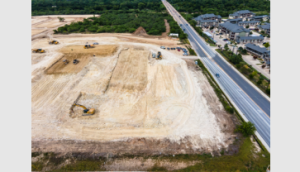

Multiple aerial drone and daily log photos taken between May 31 and June 6 document current site conditions and activity.
Visual evidence confirms active site clearing, road shaping, and early pad work.
